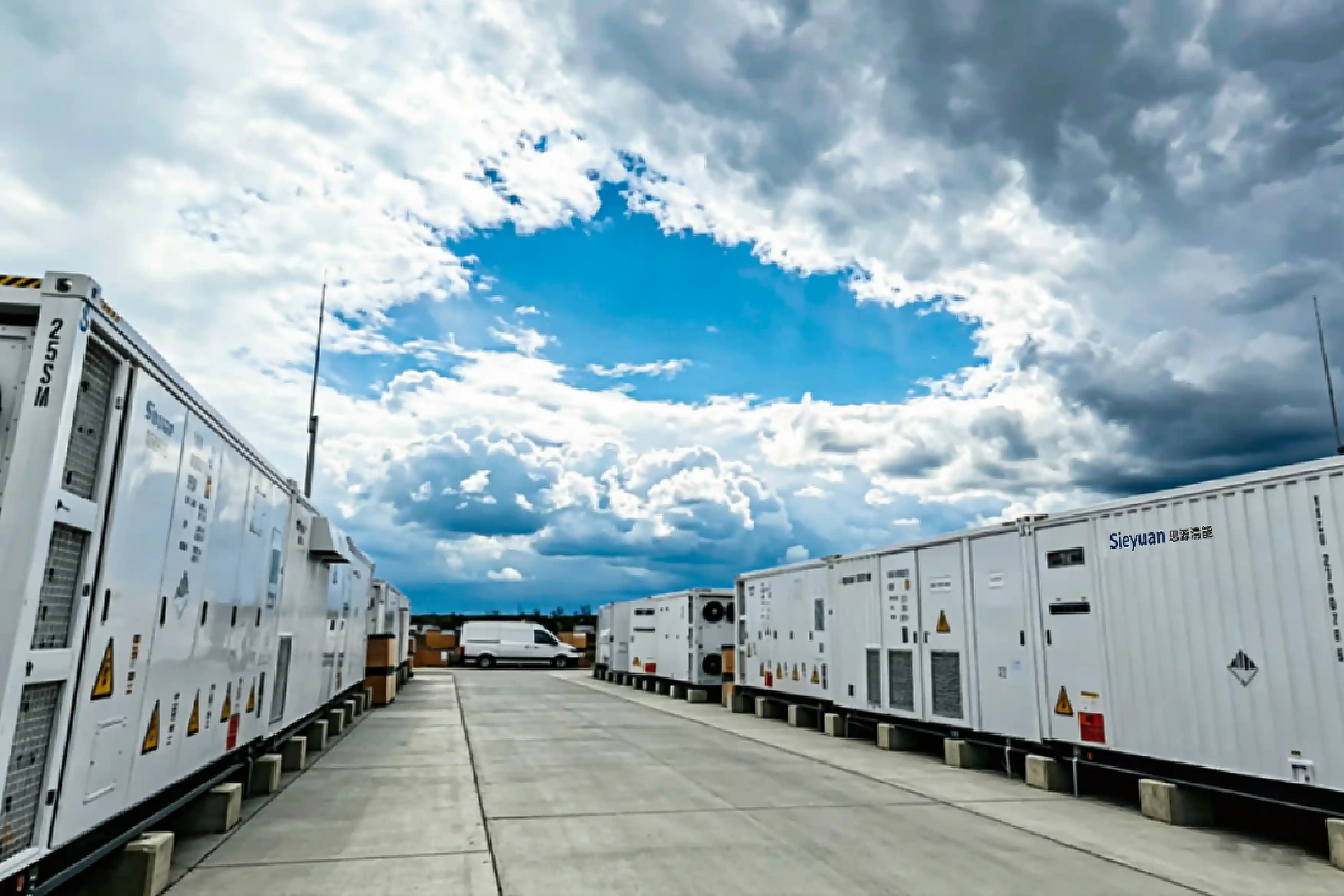

Sieyuan delivered a 49 MW / 98 MWh utility-scale battery energy storage system in Romania within five months, meeting EU grid-compliance requirements.
Utility-Scale BESS Supporting Romania's Renewable Energy Transition

Sieyuan Electric successfully delivered a 49 MW/98 MWh battery energy storage system (BESS) in Romania within a tight five-month timeline, overcoming stringent EU grid compliance requirements and complex cross-border logistics. Featuring an all-in-one AC/DC integrated architecture, the system reduces land requirements and construction costs by 30%. Backed by intelligent manufacturing, modular product design, and end-to-end project management, Sieyuan ensured seamless execution from factory to site. The project demonstrates Sieyuan's capability to deliver turnkey energy storage solutions for the European market while supporting Romania's renewable energy transition through enhanced grid stability and reliability.
Project Overview
Project Background
Romania is rapidly advancing its renewable energy transition, with Transylvania emerging as a key hub for clean energy development. As the country moves toward a greener, more resilient power system, energy storage has become increasingly important for enhancing grid stability and integrating renewable generation. To support this transition, Sieyuan Electric delivered a 49 MW/98 MWh battery energy storage system (BESS). Designed to provide two hours of energy storage, the system helps balance renewable power fluctuations while improving grid reliability and operational flexibility.
Key Challenges
High compliance and grid-connection standards — As an EU member state, Romania enforces stringent technical and safety requirements for grid-connected energy storage systems. The project required full compliance with local grid codes and rigorous certification and grid compliance testing, without compromising quality or system performance.
Aggressive delivery schedule — The client required an exceptionally short lead time from order confirmation to on-site delivery. The project schedule was tightly aligned with a predefined grid connection window, leaving minimal margin for delay. Meeting this deadline required close coordination across manufacturing, procurement, logistics, and project management teams.
Complex global logistics and end-to-end project management — Transporting large-scale energy storage equipment involved inland transportation, customs clearance and sea freight. Coordinating these activities across multiple countries and stakeholders required meticulous planning and real-time execution to ensure on-time delivery.
Sieyuan Solution
Modular product design — The system integrates liquid cooling, battery packs, PCS, and BMS into a standardized 20-foot container. This all-in-one design eliminates the need for separate battery and PCS containers, simplifying transportation, installation, and commissioning while improving overall deployment efficiency.
Large-scale intelligent manufacturing — Leveraging its intelligent manufacturing base, Sieyuan ensured high-precision production and consistent product quality. Agile supply chain management shortened the manufacturing cycle by approximately 20% compared with industry standards.
Global logistics and end-to-end project management — A dedicated cross-functional team managed every stage of project execution, from factory dispatch and ocean transportation to European inland logistics and final on-site delivery. Early coordination with local authorities and grid operators further streamlined installation and accelerated grid connection, ensuring smooth project implementation.
Technical Highlights
Compact footprint with lower construction costs — The AC/DC integrated architecture, combined with a mirrored back-to-back layout, reduces land requirements and construction costs by 30% while significantly increasing power density. For the European market, where land availability is limited and construction costs remain high, this compact design delivers substantial commercial value.
Pre-assembled & ready to run — Fully assembled and shipped as a complete integrated unit, eliminating on-site assembly of major components, reducing installation risk, and accelerating deployment. The standardized container design and pre-integrated delivery demonstrate reliable cross-border project execution.
Seamless global logistics and full-cycle team collaboration — The Sieyuan team provided end-to-end oversight of sea freight and export customs, ensuring timely, damage-free arrival at port. Beyond transportation, the team coordinated closely with the client's local staff and provided on-site technical support for unloading and grid connection.
